Cut TNB Maximum Demand
Charges With EasiEMS
Uses AIoT-powered monitoring and forecasting to help businesses avoid costly peak demand charges. REQUEST FOR DEMO

Starting 1 July 2025, Tenaga Nasional Berhad (TNB) revised its Maximum Demand (MD) charges for medium-voltage non-domestic customers under the Time-of-Use (TOU) scheme to RM97/kW. While this might seem like just another tariff change, the reality is more urgent: just one unexpected 30-minute power spike during peak hours (2pm – 10pm) can cost your business thousands of ringgit.

That’s where EasiEMS comes in. Our Smart Peak Demand Control system empowers you with real-time visibility, predictive alerts, and control — all aimed at helping you avoid costly MD penalties.

Why TNB Maximum Demand (MD) Charges Matter

Under TNB’s TOU scheme:

  • Peak Hours: 2:00 PM – 10:00 PM (Monday to Friday)
  • Off-Peak Hours: 10:00 PM – 2:00 PM (including weekends and holidays)

Your MD is calculated based on the highest 30-minute average kW usage during these peak hours. With the new charge of RM97.06/kW (RM30.19 for Capacity + RM66.87 for Network), this adds up quickly — especially for energy-intensive industries.

Even a brief spike in demand can lock you into a higher monthly MD charge, even if your average consumption is low.

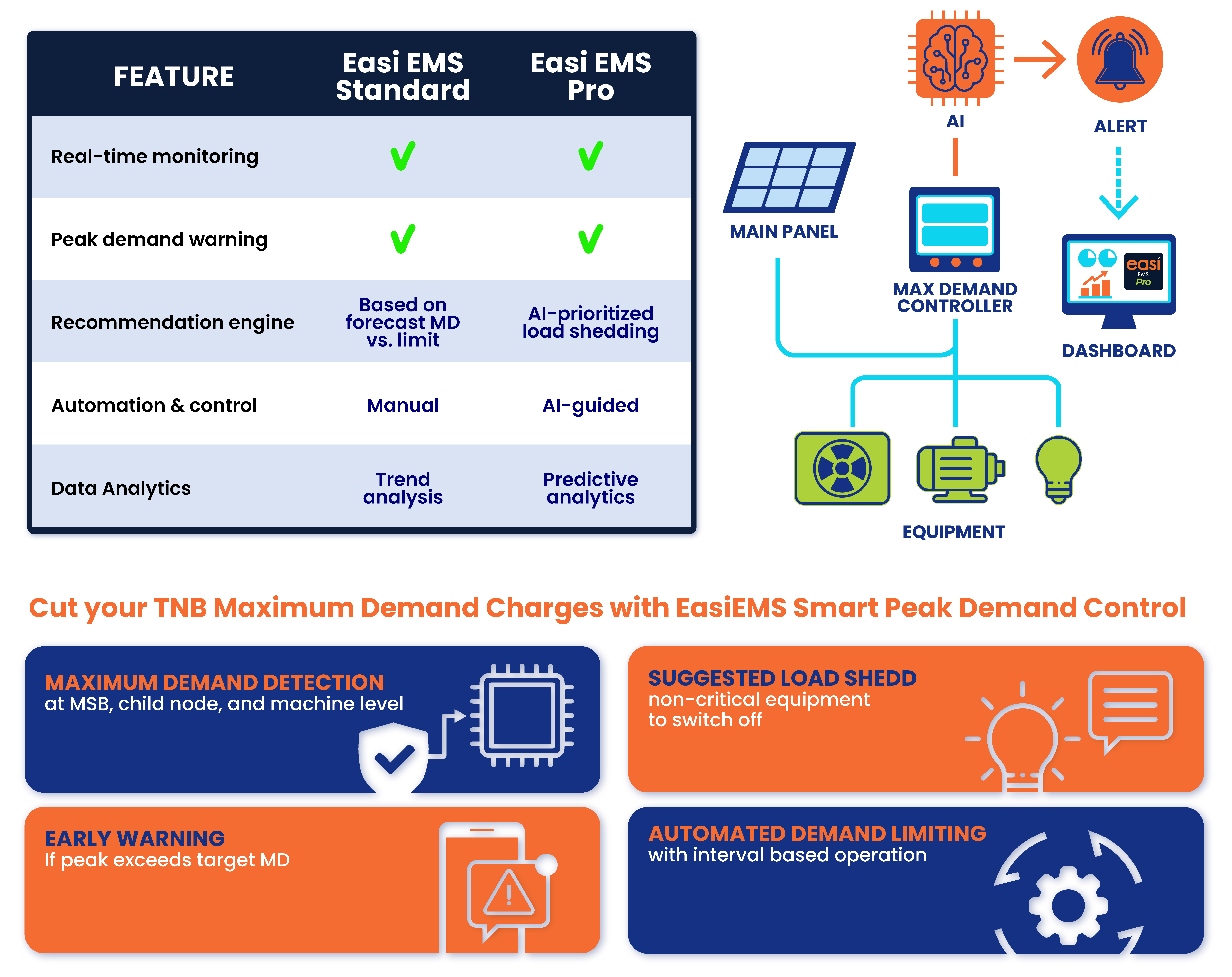

Meet EasiEMS – Granular MD detection (Beyond MSB Level)

EasiEMS is designed to provide insight and control at every level:

  • Main Switch Board (MSB) Level– Real-time monitoring aligned with TNB’s 30 mins MD calculation
  • Child Node Level – Pinpoint which distribution boards cause peak demand
  • Machine Level– Identify the exact equipment contributing to MD spikes

Early Maximum Demand Warning System – Stop MD Before It Happens

EasiEMS continuously calculates your 30-minute running average demand, just like TNB’s meter.

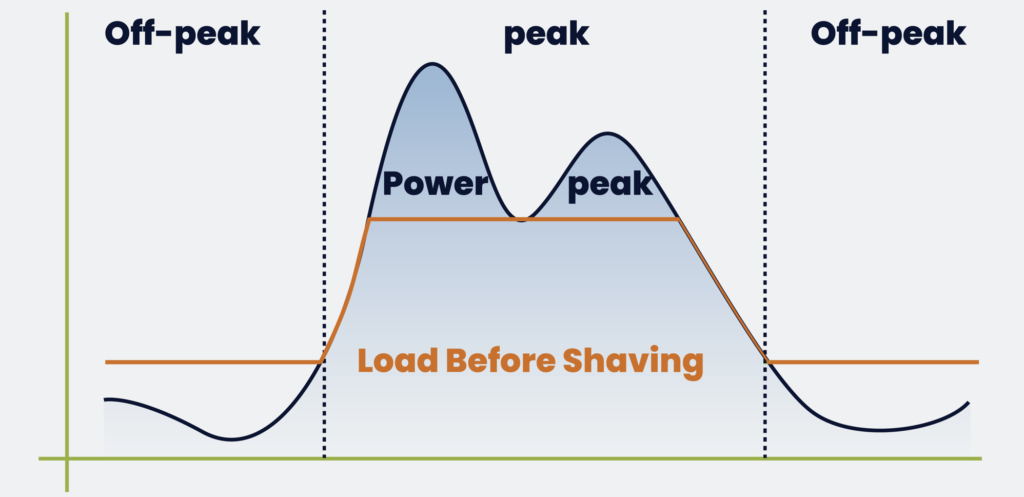

Example Scenario:

  • Target MD Limit: 800 kW
  • Current Average at 2:15 PM: 750 kW -> early warning triggered
  • Projected 30-Minute Peak: 810 kW (if no action taken)

At this point, EasiEMS triggers an Early Warning via Telegram/WhatsApp, Email, or the Mobile App, with recommendations on what actions to take — before an MD breach happens.

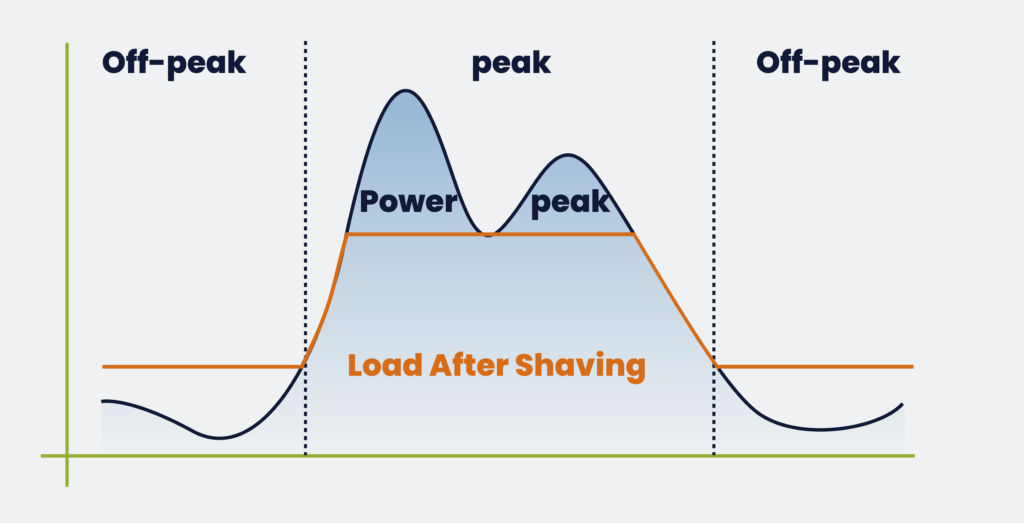

Smart Load-Shedding – Automated Recommendations in Real Time

EasiEMS goes beyond alerts. It recommends exact actions based on equipment type, runtime, and load priority.

Equipment Rated Demand (kW) Suggested Action
AHU 3 (Office Zone B) 25 Switch off for 30 minutes
Air Compressor 2 45 Delay operation for 15 minutes
Chiller 2 90 Temporarily reduce setpoint/cycle-off
Production Line C Fan 5 10 Switch off for 15 minutes

Automated Demand Limiting Control

For key equipment connected to the Max Demand Limiting Controller, EasiEMS enables:

🖥 Remote Switching – One-click OFF from the dashboard

🤖 Auto-Control Mode – Auto switch-off for 15 or 30-minute intervals on selected loads

This ensures immediate action, even when staff can’t respond fast enough.

Case Study Simulation – What You Can Save

By strategically reducing MD, you could save tens to hundreds of thousands of ringgit annually:

MD Reduction (kW) TOU MD Charge
(RM97/kW)
Monthly Saving (RM) Annual Saving (RM)
20 RM1,940 RM1,940 RM23,280
50 RM4,850 RM4,850 RM58,200
100 RM9,700 RM9,700 RM116,400
200 RM19,400 RM19,400 RM232,800

Case Study Simulation – Before vs After EasiEMS Implementation

A semiconductor plant previously recorded an MD of 2550 kW during peak hours, resulting in a monthly MD charge of RM82,501 (850 kW × RM97.06). After installing EasiEMS, the plant successfully reduced its peak demand to 2450 kW by automatically cycling off two air compressors and rescheduling non-critical AHUs during the 2 PM to 10 PM TOU window.

This 100 kW reduction translated to a direct monthly saving of RM9,706 and an annual saving of RM116,472. Additionally, by reviewing machine-level MD data, the plant optimized chiller operations, achieving further energy savings beyond the MD cost reduction.

Before vs After EasiEMS – MD Cost Comparison

Item Before EasiEMS After EasiEMS
Maximum Demand (kW) 2550 kW 2450 kW
MD Charge Rate (TOU) RM97.06/kW RM97.06/kW
Monthly MD Charge 2550 × RM97.06 = RM82,501 2450 × RM97.06 = RM77,648
Monthly Saving RM9,706.00
Annual Saving RM116,472.00

Based on non-domestic medium voltage with ToU, Max demand charges (during peak hours):
Capacity Charge: RM30.19/kW + Network Charge: RM66.87/kW = RM97.06/kW

ToU scheme has 2 time zones (Peak and Off-Peak):

  1. Monday to Friday: Peak: 2:00pm to 10:00pm
    Off-Peak: 10:00pm to 2:00pm
  2. Saturday, Sunday and Public Holidays*:
    Off-Peak all day (24 hours) ← Lower Footer

MD is measured in Kilowatt (kW). MD is the highest level of electricity demand recorded by TNB meter during a 30-minute interval in a month that occurs during peak period.
The kW amount charged to customers is based on Recorded MD (kW) x *MD Charge Rate

Non-Domestic Medium Voltage ToU Tariff

Energy Charge

For all kWh during the peak period

sen/kWh 31.32

Energy Charge

For all kWh during the off-peak period

sen/kWh 27.23

Capacity Charge

For each kilowatt of maximum demand per month during the peak period

RM/kW 30.19

Network Charge

For each kilowatt of maximum demand per month during the peak period

RM/kW 66.87
Retail Charge RM/month 200.00

Source: https://www.mytnb.com.my/tariff/index.html?v=1.1.29

EasiEMS Smart Peak Demand Control

Conclusion - Lower Your Energy Bills Without Sacrificing Operations

When just 30 minutes of high usage can cost you thousands, you need more than manual monitoring. EasiEMS makes energy-saving automatic and stress-free.

With smart alerts, equipment-level insights, and built-in load control, you can reduce Maximum Demand charges while improving overall energy efficiency — without affecting daily operations.

Whether you’re managing a factory, commercial building, or industrial site, EasiEMS gives you the visibility and control to save money every month.

Let us show you how much you could be saving. Reach out to our team to assess your eligibility and project fit at our contact page to speak with our technical experts.
